ERP Tutorial ERPWork OrdersManufacturingTutorial

ERP Tutorial 6 — Work Orders: BOM Explosion, Routing & Plan-to-Produce

T
TechnoPKG
2026-07-06 📖 6 min read 👁 12 views

This is where the whole series converges. Sales Orders created demand (Tutorial 1), MRP planned it (Tutorial 4), and S&OP committed to it (Tutorial 5) — work orders are where the plan finally becomes production. Open ERP → Work Orders, subtitled DP Sound Systems Inc — Plan-to-Produce.

The Work Orders List

Each row is one production run, and each carries its BOM and Routing badge — the what and the how attached to every order:

WO IDItemQtyBOMRoutingStatus
WO-2025-0001SmartBar Pro 50010BOM-001RTG-001Released
WO-2026-0620-0002SmartBar Pro 5005BOM-001RTG-001Draft
WO-SOP-025-Q3-ITM-001SmartBar Pro 500130BOM-001RTG-001Draft
WO-SOP-025-Q3-ITM-002HomeTheatre HT-70042BOM-002RTG-002Draft
WO-SOP-025-Q3-ITM-003PortablePA PA-200168BOM-003RTG-003Draft
WO-2026-0705-0006PortablePA PA-2001BOM-003RTG-003Completed

Look at the middle three IDs. Those are the exact work orders the S&OP run created in Tutorial 5 — WO-SOP-025-Q3-ITM-001/002/003, one per finished good, sitting in Draft and waiting for a planner to release them. The plan we watched being made is now a queue of real production.

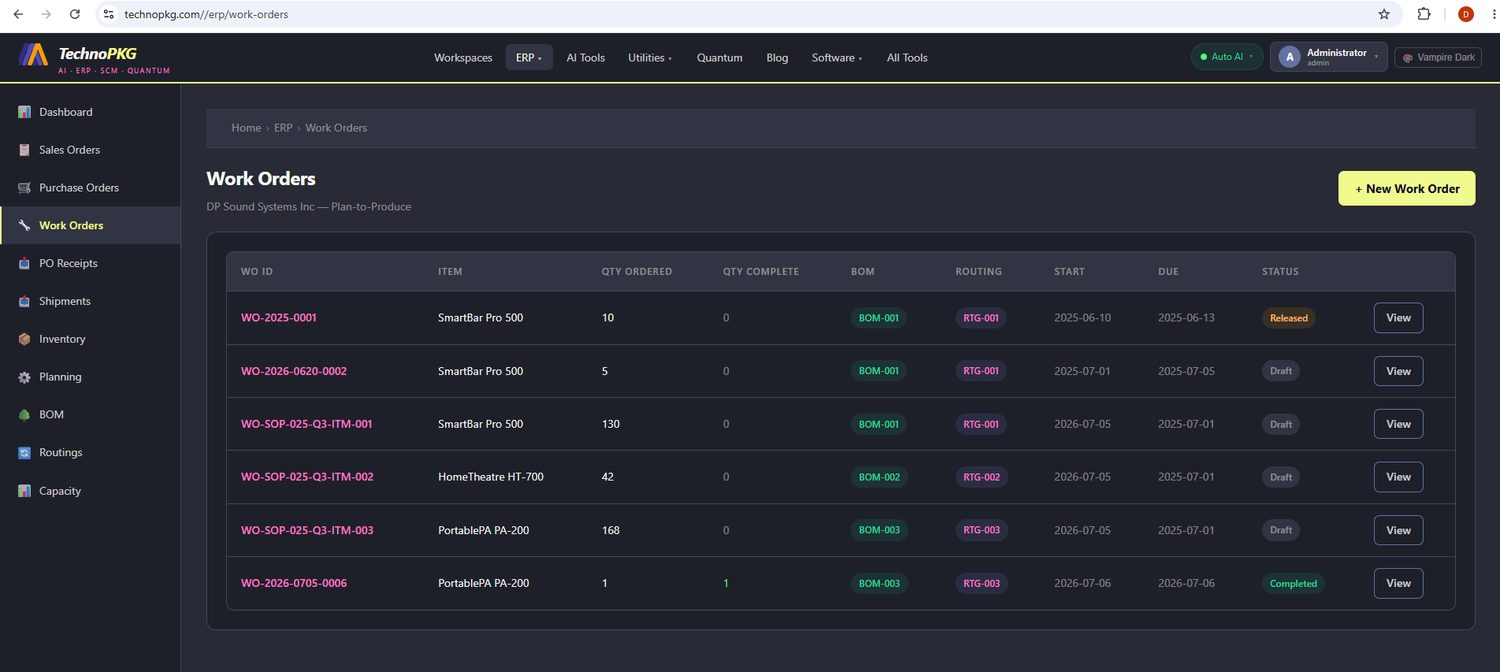

Work Orders list on the live portal
The Work Orders list — the three WO-SOP orders from Tutorial 5 sitting in Draft.
Each arrived with its BOM and routing already attached: the system pulled BOM-001/RTG-001 for the SmartBar, BOM-002/RTG-002 for the HomeTheatre, BOM-003/RTG-003 for the PortablePA, with no manual lookup.

The status column also previews the lifecycle: Draft (planned, not yet on the floor) → Released (in production) → Completed (finished and received into stock). We'll walk one order through the last step below.

Anatomy of a Work Order

Click View on WO-2025-0001 and the detail page opens: WO-2025-0001 — SmartBar Pro 500 · Qty: 10 · Start: 2025-06-10 · Due: 2025-06-13 · SO: SO-2025-0001, status Released, with two action buttons — Issue Components and Complete WO.

That SO: SO-2025-0001 reference in the header is demand traceability: this production run exists because of a specific customer order — the very first sales order from Tutorial 1. From customer promise to factory floor in one clickable link.

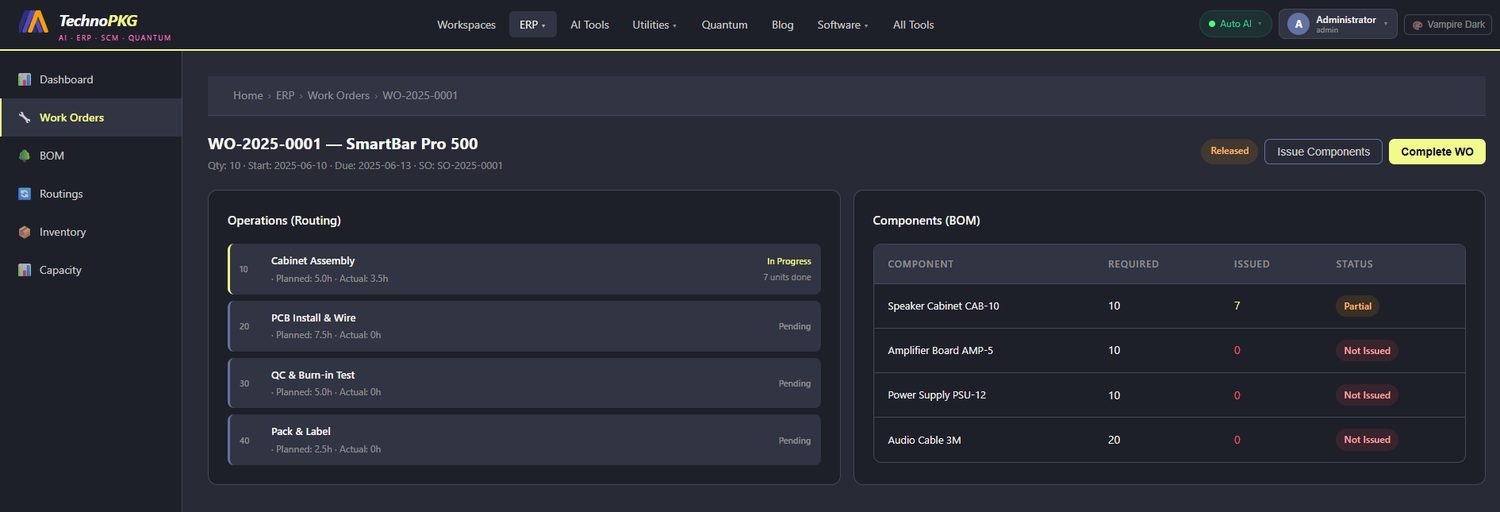

WO-2025-0001 detail with routing operations and BOM components
WO-2025-0001 — operations on the left, BOM components with issue status on the right.

The page splits into the two halves every work order is made of.

Operations (Routing) — the how

The left panel lists the four operations from RTG-001, in sequence:

OpOperationPlannedActualStatus
10Cabinet Assembly5.0h3.5hIn Progress — 7 units done
20PCB Install & Wire7.5h0hPending
30QC & Burn-in Test5.0h0hPending
40Pack & Label2.5h0hPending

Planned hours total 20 for the batch. Operation 10 is live shop-floor status: 3.5 of 5 planned hours consumed and 7 of 10 units through assembly. This planned-vs-actual pair per operation is the raw material for capacity planning — a topic we'll return to when the series reaches the Capacity page.

Components (BOM) — the what

The right panel is BOM-001 exploded for this order's quantity:

ComponentRequiredIssuedStatus
Speaker Cabinet CAB-10107Partial
Amplifier Board AMP-5100Not Issued
Power Supply PSU-12100Not Issued
Audio Cable 3M200Not Issued

Check the math on the last line: the order is for 10 units, but 20 cables are required — because the BOM calls for 2 cables per unit. Requirements here are always BOM quantity-per times order quantity. And the issue status mirrors the shop floor: 7 cabinets issued for the 7 units through assembly, everything else still waiting in stores. Issuing components is what moves stock out of on-hand inventory — the allocation side of the numbers you read in Tutorial 3.

Completing the Work Order

Click Complete WO and the system closes the loop with a confirmation banner:

✓ WO-2025-0001 completed. 10 units added to inventory.

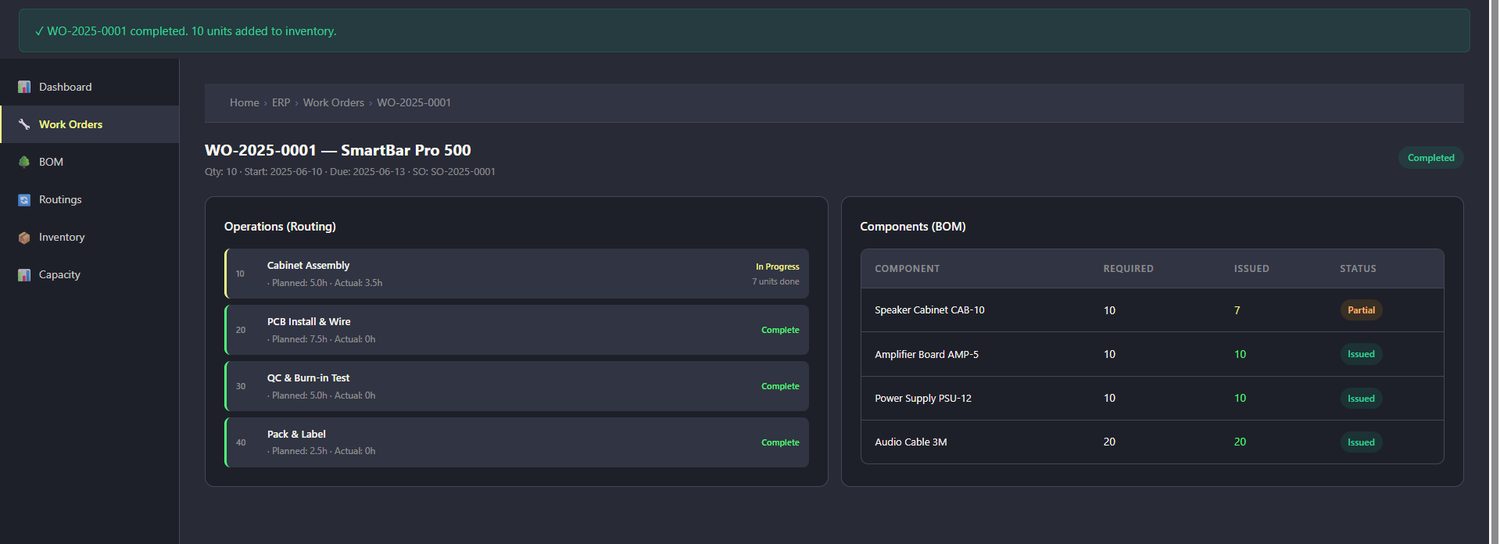

Completed work order with components issued
After Complete WO — status flipped, components issued, 10 units received into stock.

The status chip flips to Completed, the remaining operations mark Complete, and the component lines settle — Amplifier Board 10/10, Power Supply 10/10, Audio Cable 20/20, all Issued. The consequence lands in two other modules at once: raw components left inventory, and 10 finished SmartBar Pro 500s entered it, ready to fulfil SO-2025-0001. That single banner line is the entire plan-to-produce promise: demand in, product out.

The Lifecycle in One Line

Draft (created by S&OP, MRP, or by hand) → Released (components issue, operations log hours) → Completed (finished goods received into stock). Every work order in the list above is at one of these three stations.

Try It Yourself

  1. Open ERP → Work Orders and find the three WO-SOP-025-Q3 orders — then reread the plan in Tutorial 5 that created them.
  2. Open WO-2025-0001 and follow the SO-2025-0001 link back to the original sales order from Tutorial 1.
  3. Compare the Audio Cable requirement (20) with the order quantity (10) and confirm the quantity-per against the BOM page.
  4. Watch a component line change status when you use Issue Components on a released order.

Next up: Tutorial 7 — Bill of Materials, a close look at the structure every one of these work orders was born from: BOM-001's multi-level tree and its live cost explosion.

Tags: ERPWork OrdersManufacturingTutorial
